Case study

Seeds Lane

Brownhills

Five three-bedroom detached bungalows built on Seeds Lane, Brownhills.

Seeds Lane, Brownhills - Five detached bungalows
Scheme
Five detached bungalows
Type
New build
Site inspections
19
Services
2
Status
Complete 2023

The story of the job

Five three-bedroom detached bungalows on Seeds Lane in Brownhills. We brought in our supply chain partners to provide Building Control and the 10 Year Structural Warranty for the client.

Foundations started from December 2022, dug to the structural engineer's design at 0.6m wide and 1.0m to 1.3m deep in sand and gravel with small clay pockets. Block and beam floors followed by April 2023, with air bricks in position and a damp-proof course under the precast beams.

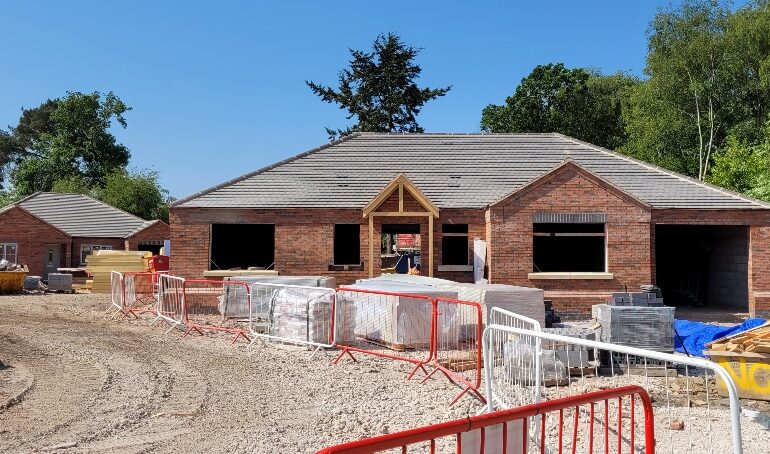

Blockwork and brickwork came next, and by May 2023 roof trusses were erected to the manufacturer's design with wind bracing completed and girder trusses fully fixed. Foundations on later plots were still going in that month, with structural mesh reinforcement, so the site ran at several stages at once.

First fix plumbing, electrics and studwork ran from June to September 2023, with cavity wall insulation going in during July. By the end of October 2023 the drain test had been witnessed and all internal and external works were complete, with fire doors and overhead closers fitted to the integral garages.

01

The challenge

Five detached bungalows went up on sand and gravel with small clay pockets, with foundations 1.0m to 1.3m deep to the structural engineer's design. The plots ran at different stages, with foundations still going in during May 2023 while roof trusses were up on others.

02

How we ran it

We carried out 19 inspection visits through the build. Each key stage was looked at on site: foundations before concrete, block and beam floors, roof trusses, first fix and drainage.

03

The result

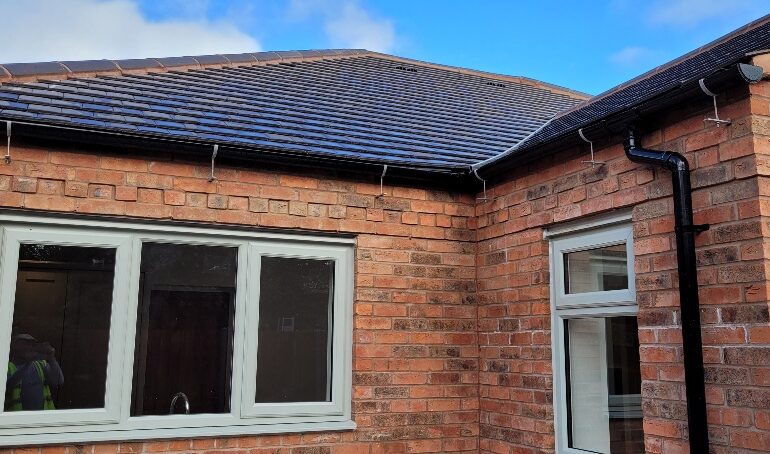

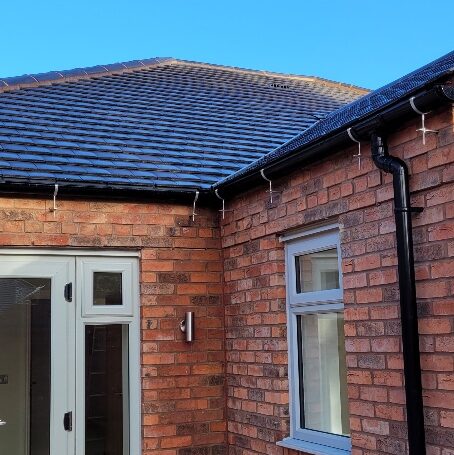

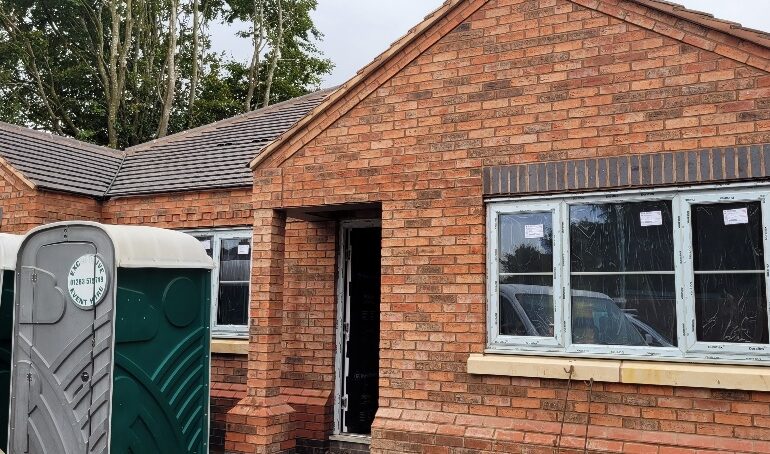

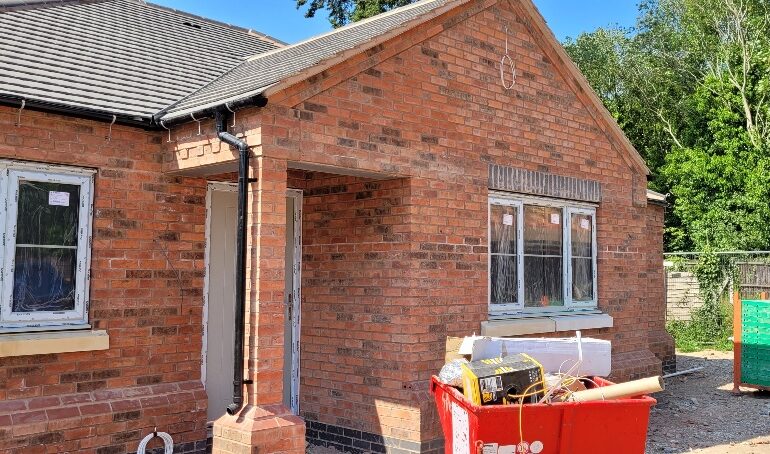

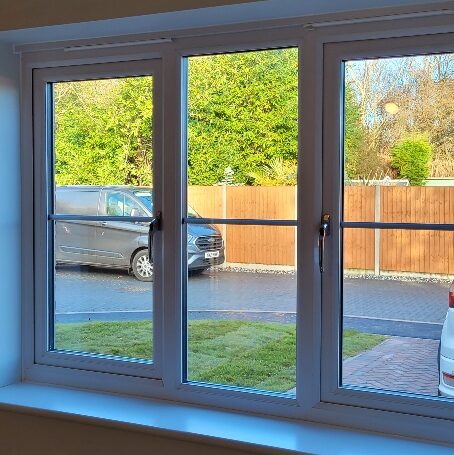

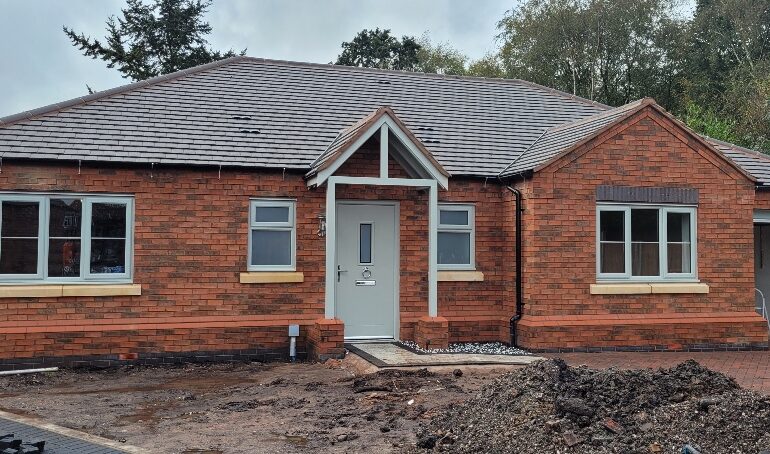

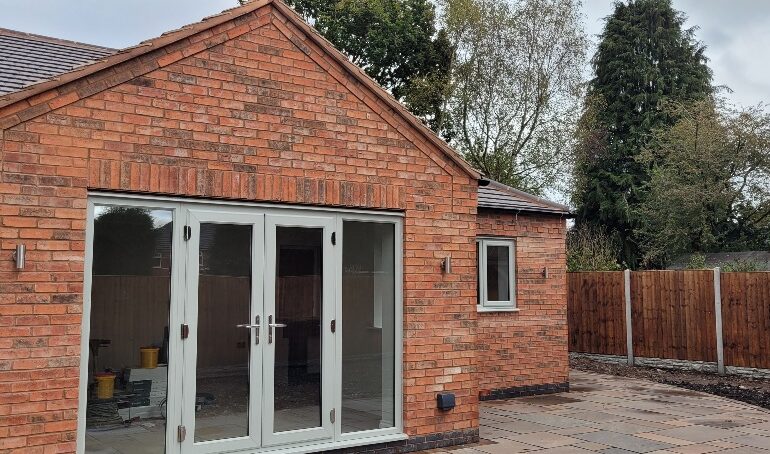

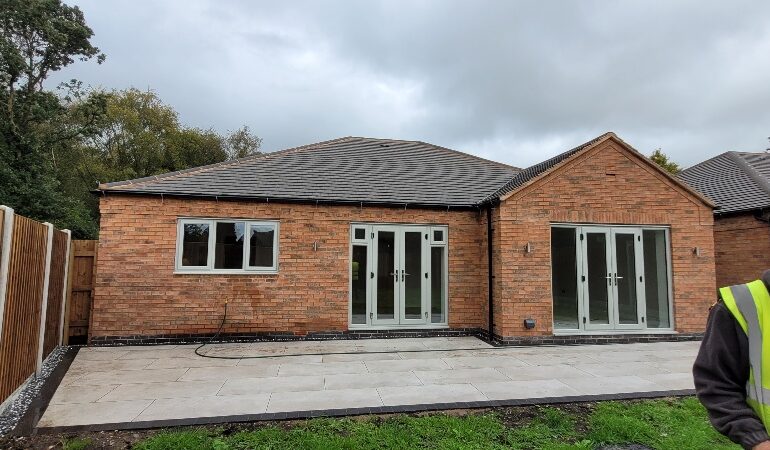

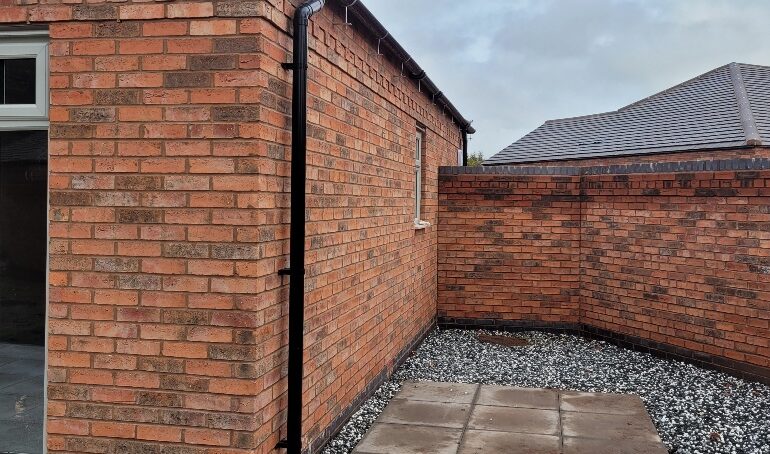

At the visit on 31 October 2023 the drain test was witnessed and all external and internal works were complete. Guttering and downpipes were connected and clipped, and fire doors with overhead closers were fitted to the integral garages.

On site

The build, stage by stage

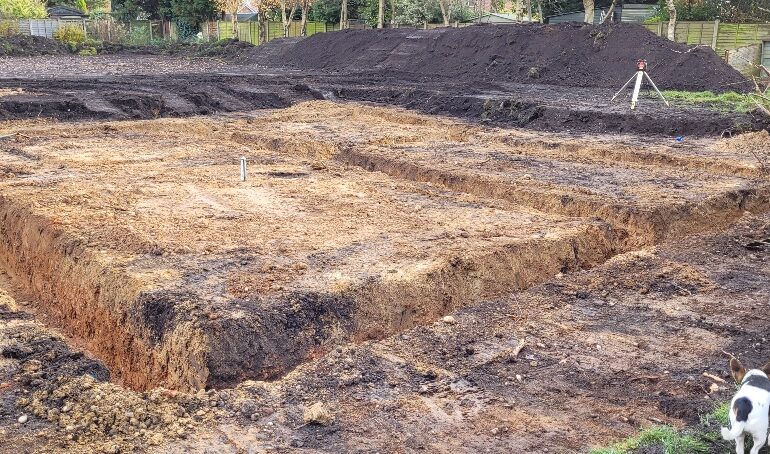

  1. Seeds Lane, Brownhills - Foundations

    Jan 2023

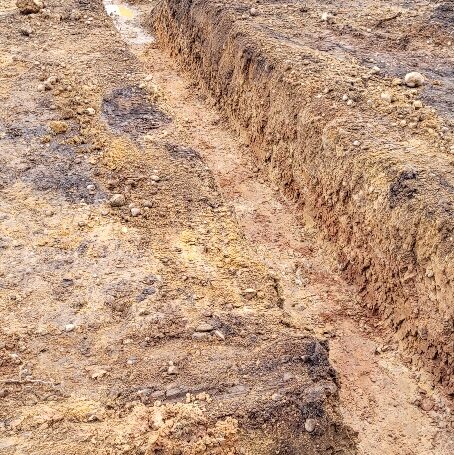

    Foundations

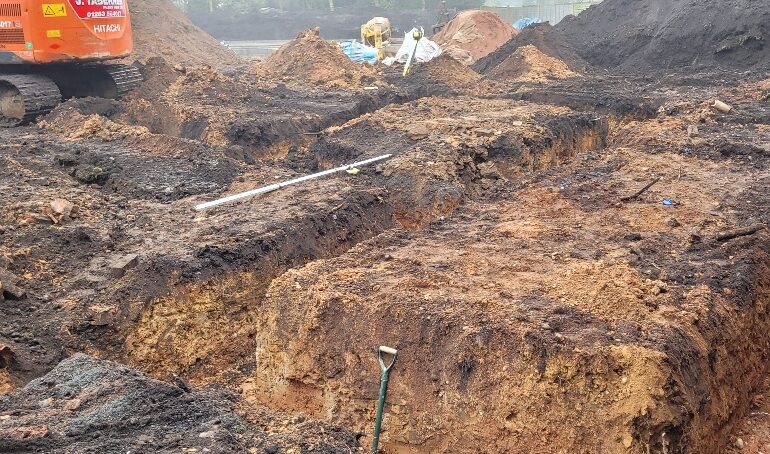

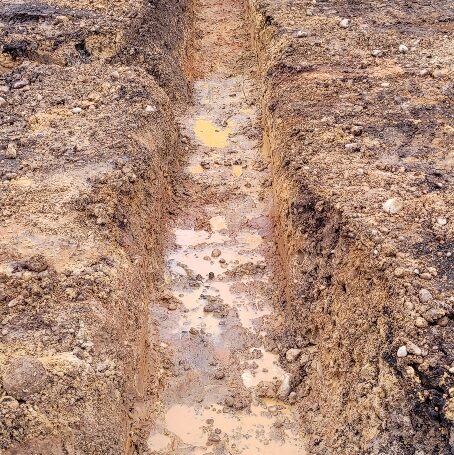

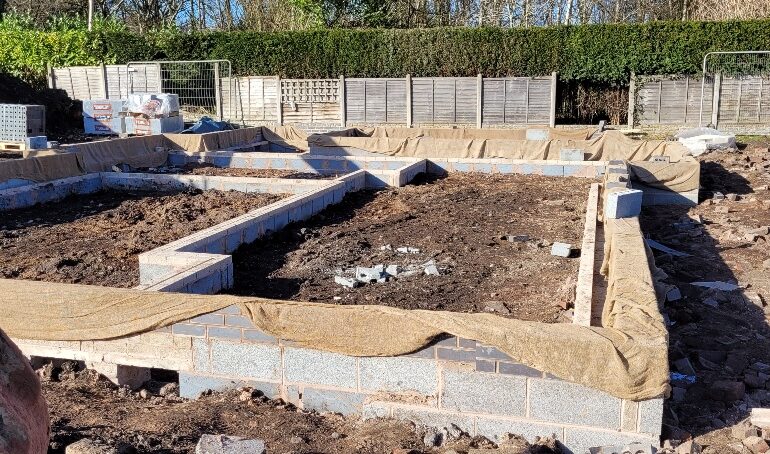

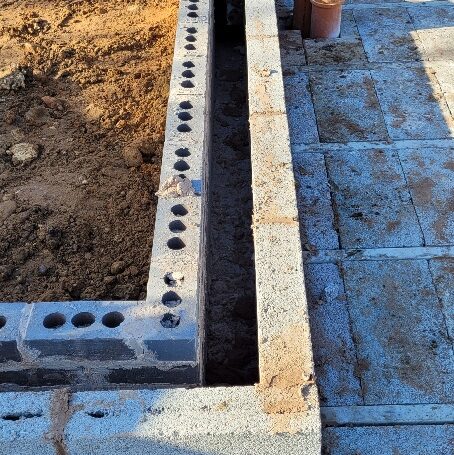

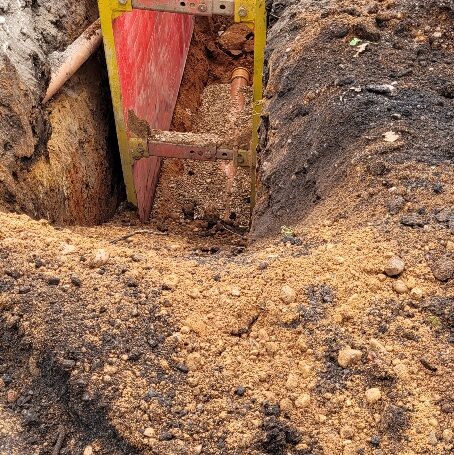

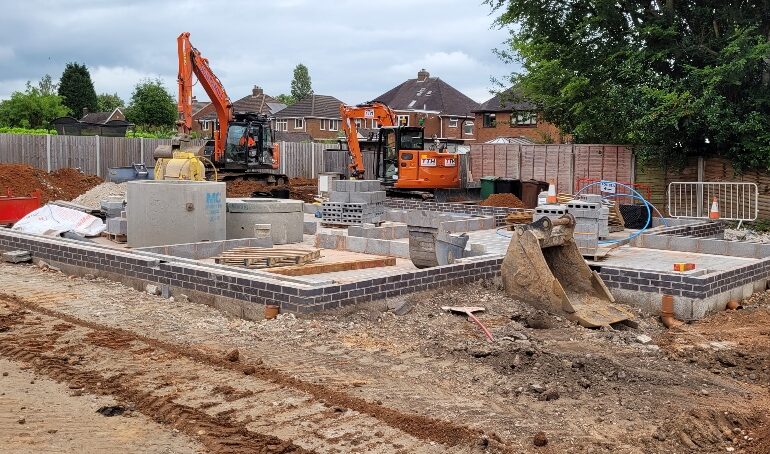

    Foundations were dug to the structural engineer's design, 0.6m wide and 1.0m to 1.3m deep in sand and gravel.

  2. Seeds Lane, Brownhills - Floors

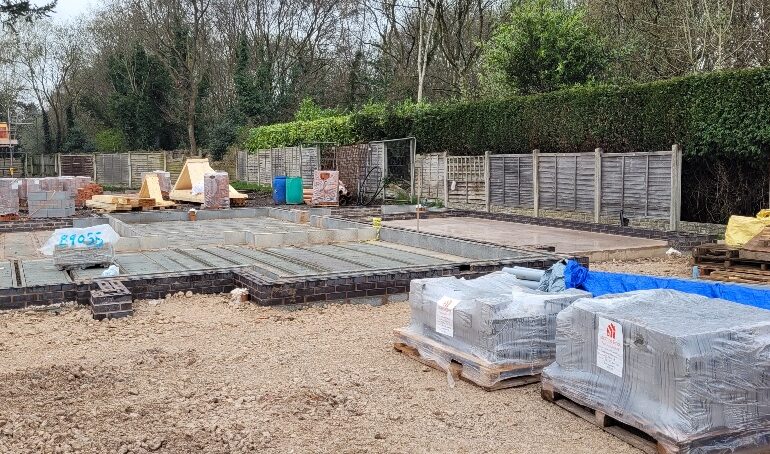

    Apr 2023

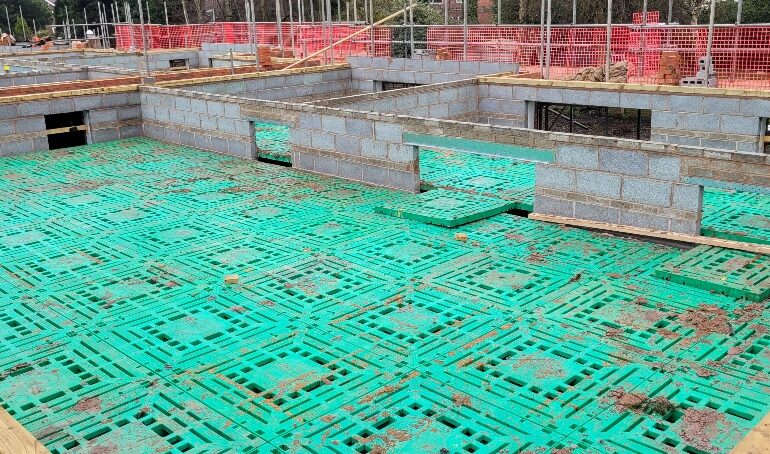

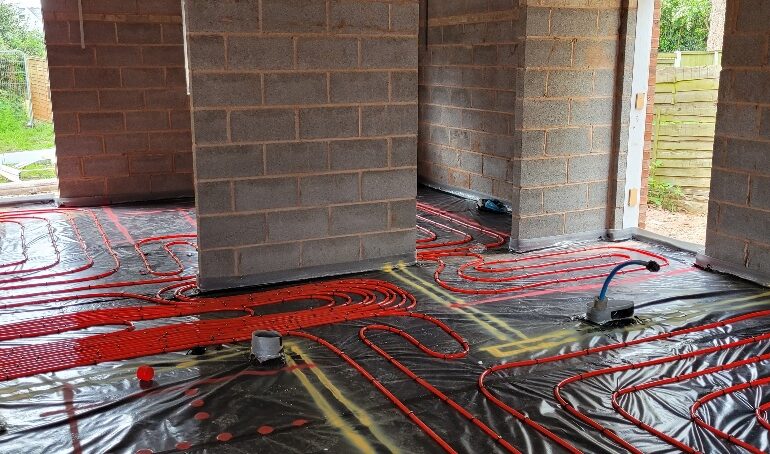

    Floors

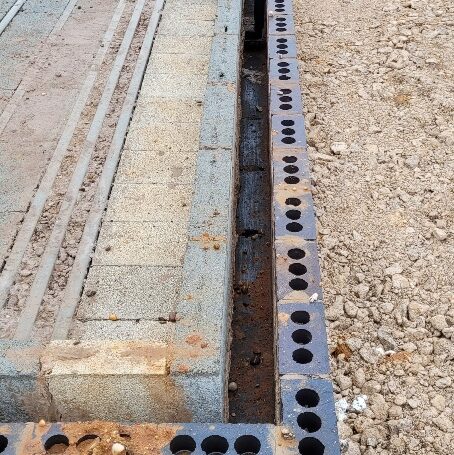

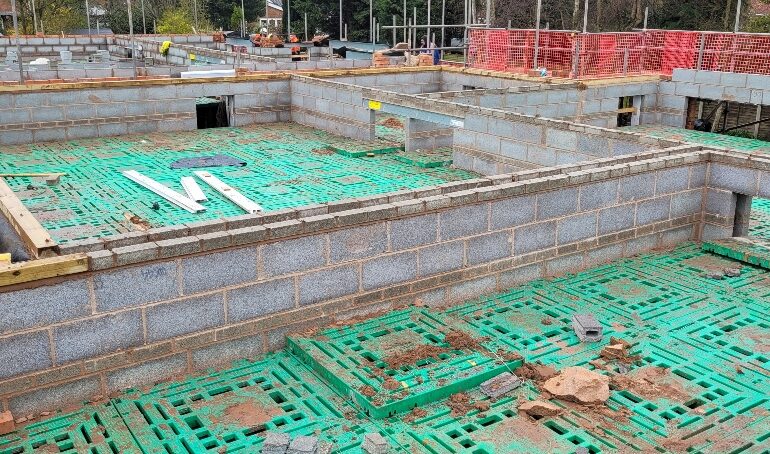

    Block and beam floors went in with air bricks in position and a damp-proof course under the precast beams.

  3. Seeds Lane, Brownhills - Walls

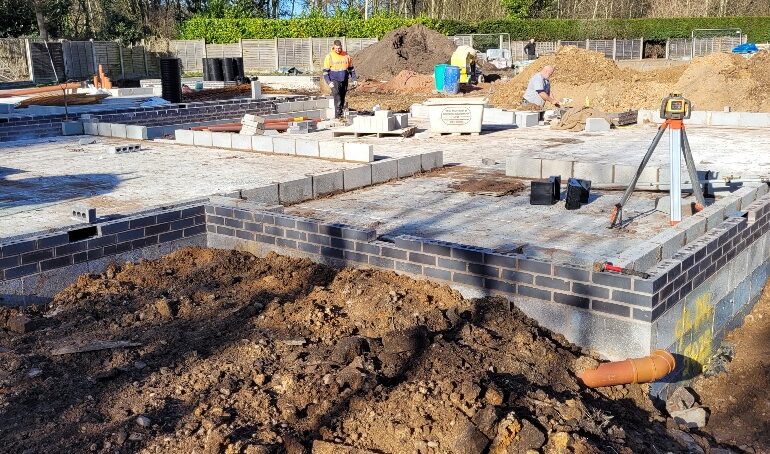

    Apr 2023

    Walls

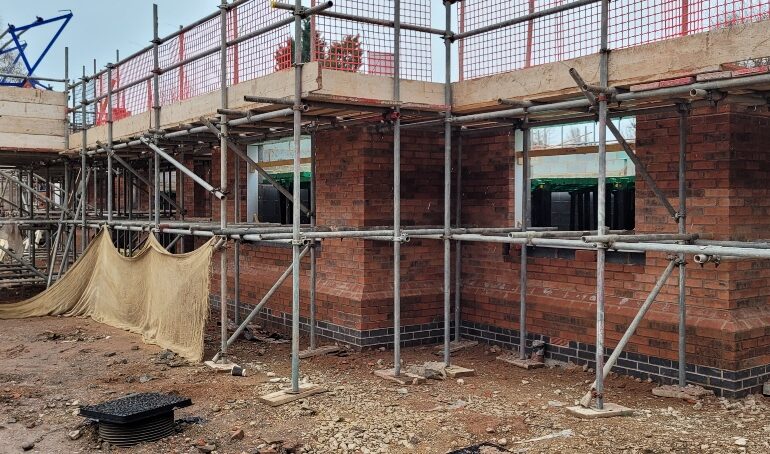

    Superstructure blockwork and brickwork went up from the finished floors.

  4. Seeds Lane, Brownhills - Roof

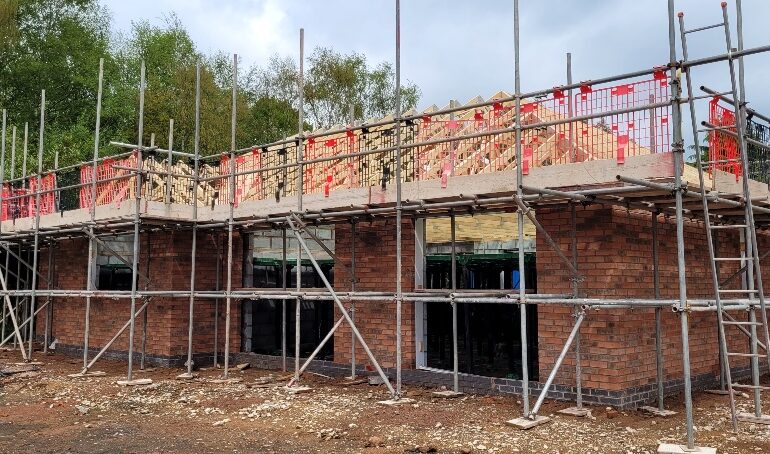

    May 2023

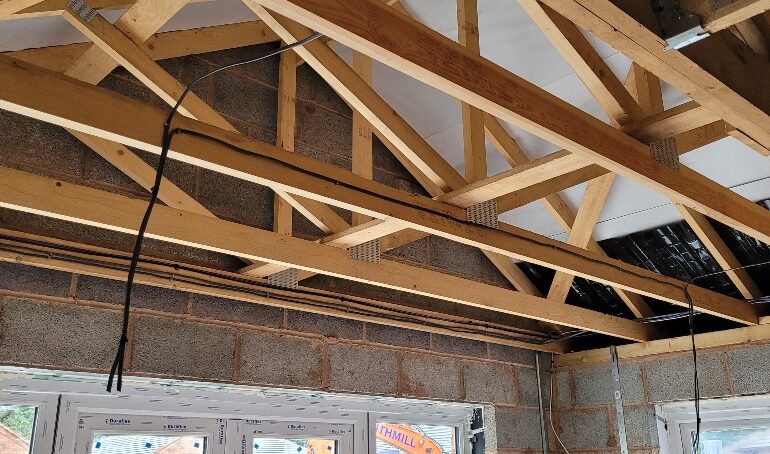

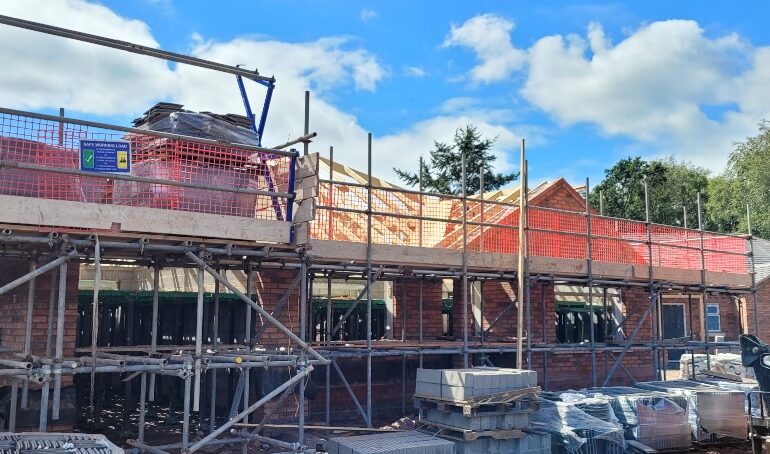

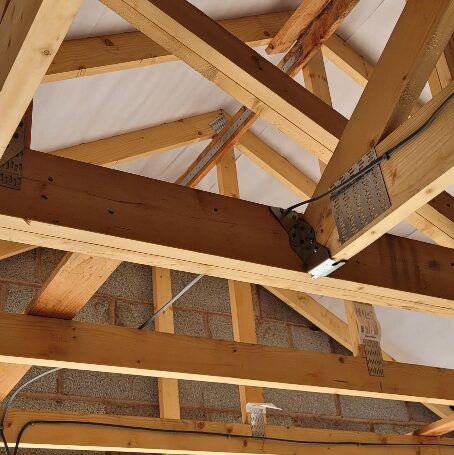

    Roof

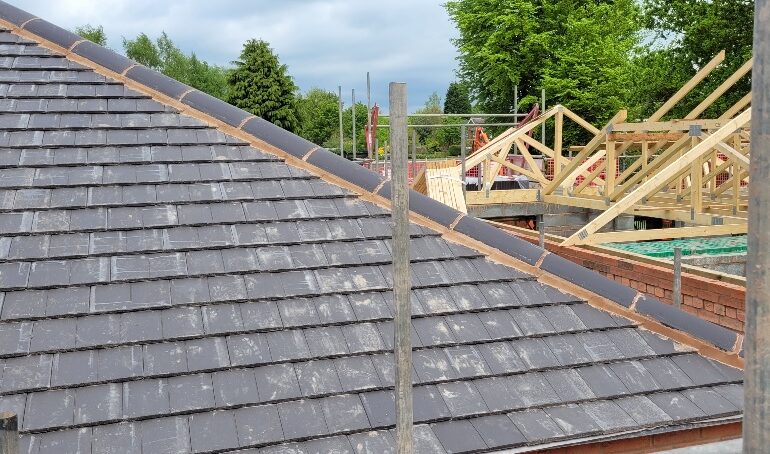

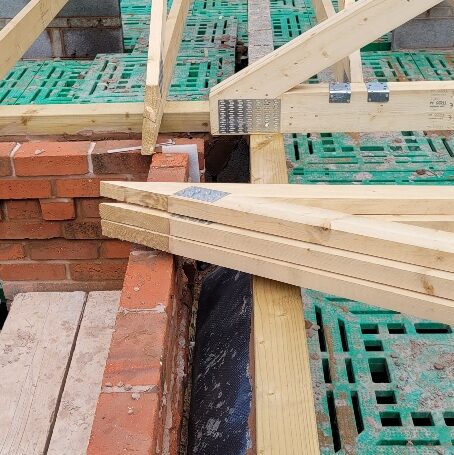

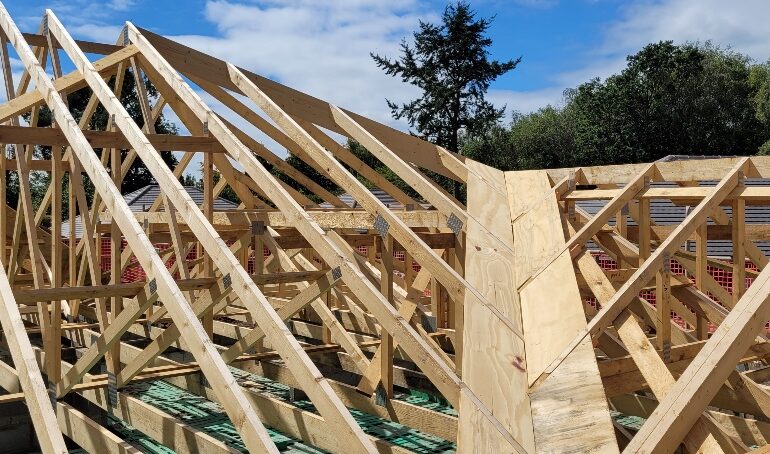

    Roof trusses were erected to the manufacturer's design, with wind bracing completed and girder trusses fully fixed.

  5. Seeds Lane, Brownhills - First fix

    Jun 2023

    First fix

    First fix plumbing and electrics were completed and the internal timber stud partitions went in.

  6. Seeds Lane, Brownhills - Complete

    Oct 2023

    Complete

    The drain test was witnessed and all external and internal works were complete.
