Case study

Station Road

Bagworth

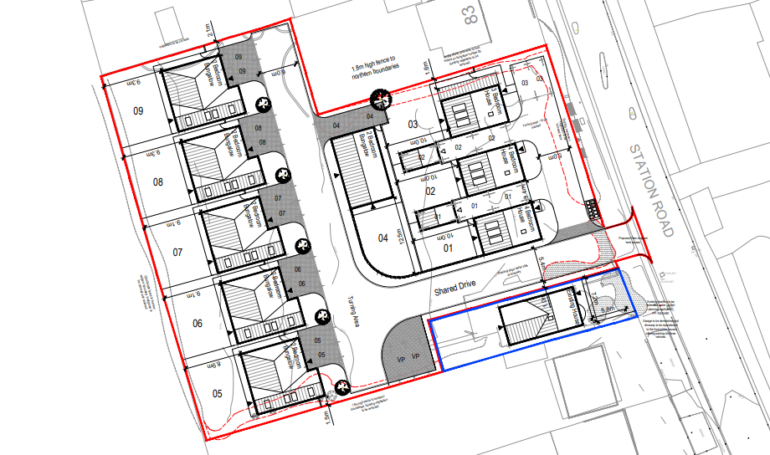

Nine detached homes, six bungalows and three houses, built on land next to Station Road in Bagworth.

Station Road, Bagworth - project photo 1
Scheme
Six bungalows and three detached houses
Type
New build
Site inspections
22
Services
8
Status
Complete 2024

The story of the job

Nine detached homes on land next to Station Road in Bagworth: six two-bedroom bungalows, one three-bedroom house and two four-bedroom houses.

We brought in our supply chain partners for Building Control and the 10 Year Structural Warranty. We also coordinated the SAP calculations, air tightness, sound insulation and ventilation testing, Energy Performance Certificates and water efficiency calculations.

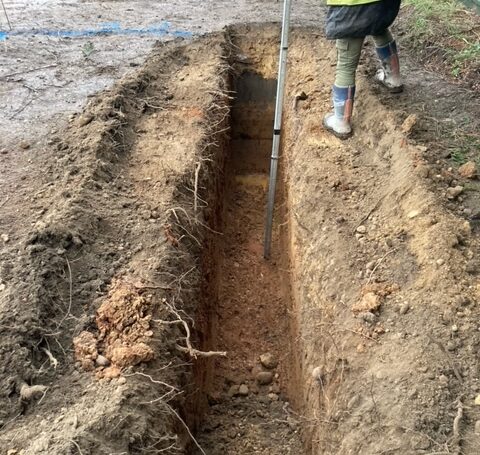

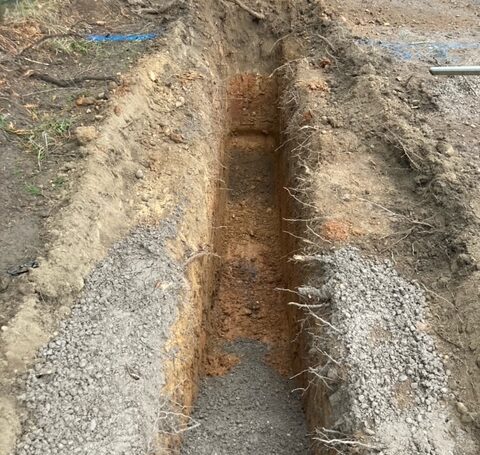

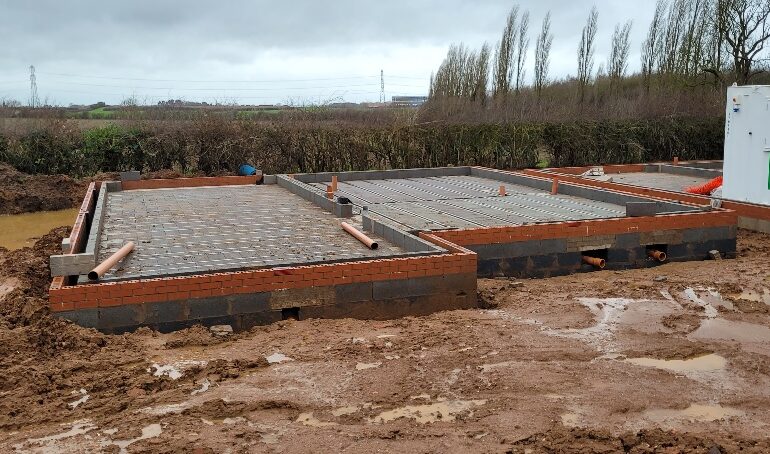

Foundations started in January 2023 to the structural engineer's design, at depths of 1.5m to 2.1m below finished floor level with two layers of B385 mesh. Waterlogged ground slowed the block and beam floors that month. Further plots followed in April and May 2023 at around 1.0m deep in sand and gravel with clay content.

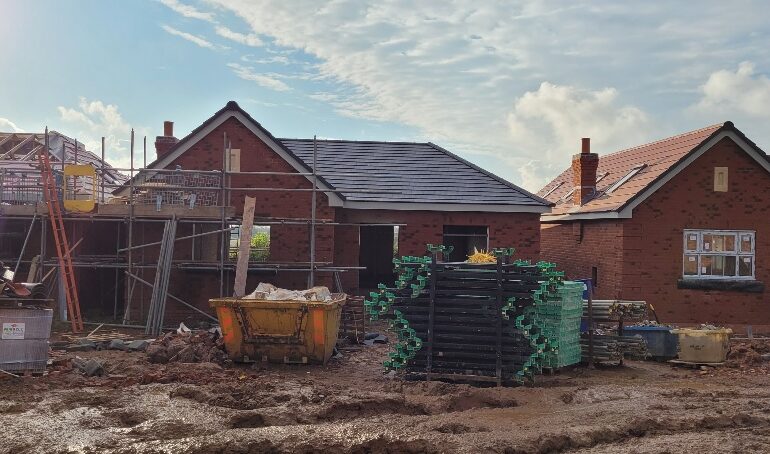

Brickwork and roof trusses followed through 2023, with breathable felt and tile battens going on by October. Roof tiling with a mechanically fixed ventilated ridge was in place by May 2024. By September 2024 drain tests had been witnessed and all internal and external works were complete.

01

The challenge

Foundation depths varied across the site, from around 1.0m on some plots to 2.1m below finished floor level on others, all to the structural engineer's design. January 2023 brought waterlogged ground that limited access and slowed the block and beam floors. The site also mixed three home types, with bungalows and houses going up together.

02

How we ran it

We coordinated Building Control, the warranty and the full set of testing and energy work, with 22 inspection visits through the build. Foundations, floors, brickwork, roofs and first fix were each looked at on site. When the ground was too wet to walk, progress was still recorded with photos from a distance.

03

The result

By September 2024 all internal and external works were complete, with drain tests witnessed. Fire doors and smoke detectors were fitted and working, and roof tiling was finished with a mechanically fixed ventilated ridge.

On site

The build, stage by stage

  1. Station Road, Bagworth - Foundations

    Jan 2023

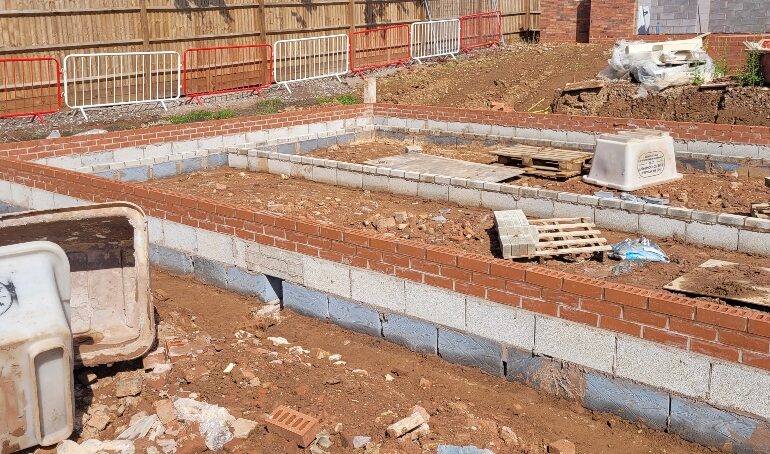

    Foundations

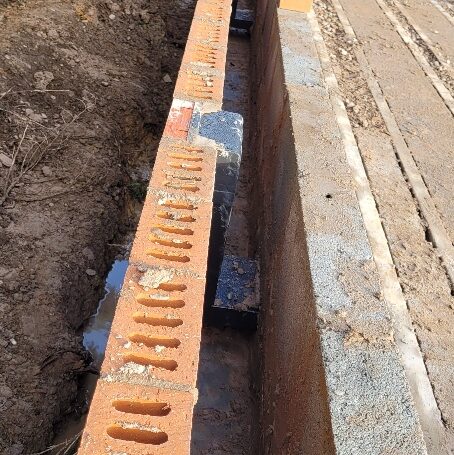

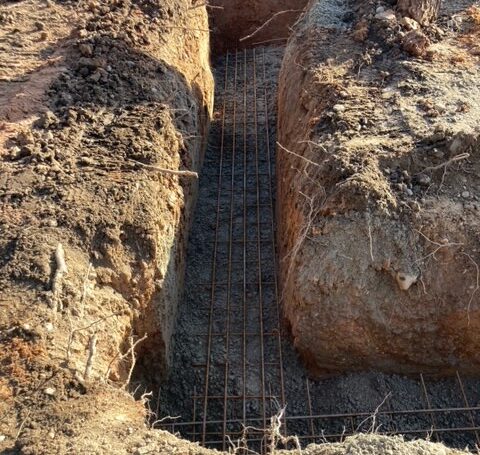

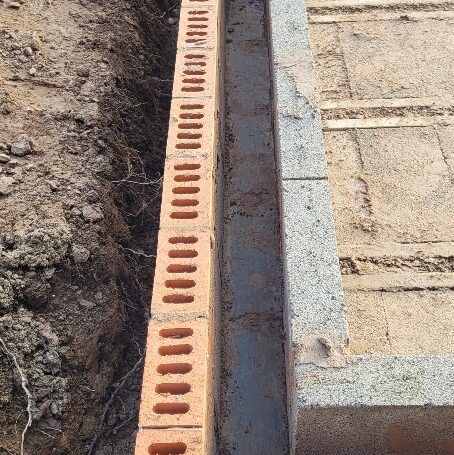

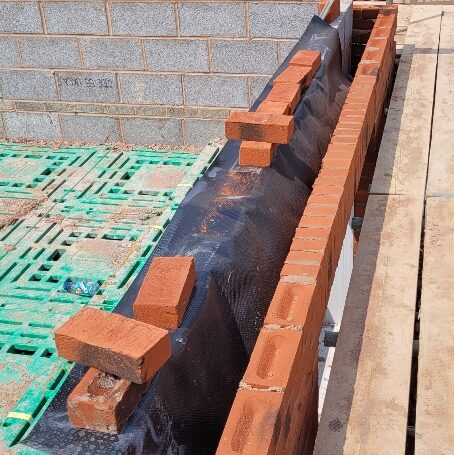

    Foundations were dug to the structural engineer's design, 1.5m to 2.1m below finished floor level, with two layers of B385 mesh.

  2. Station Road, Bagworth - Floors

    Jan 2023

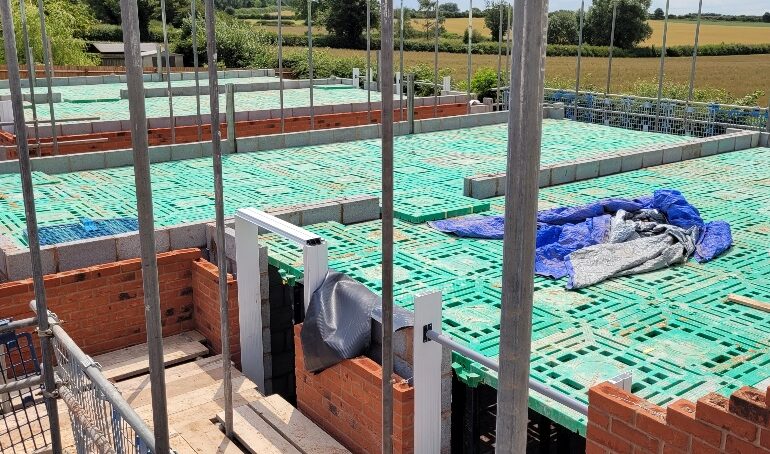

    Floors

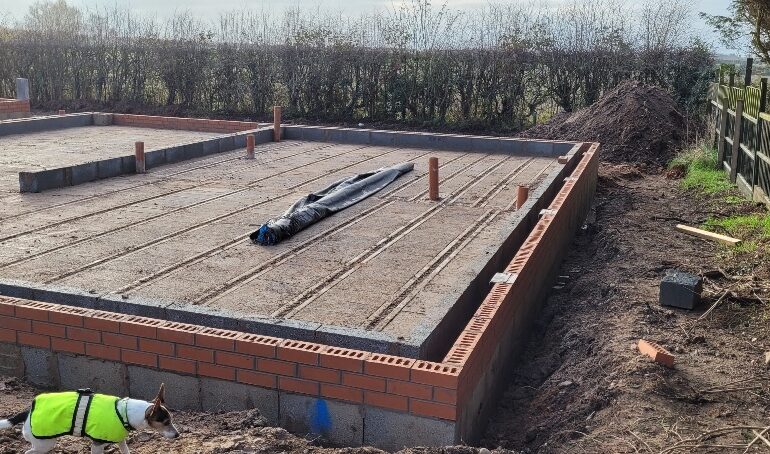

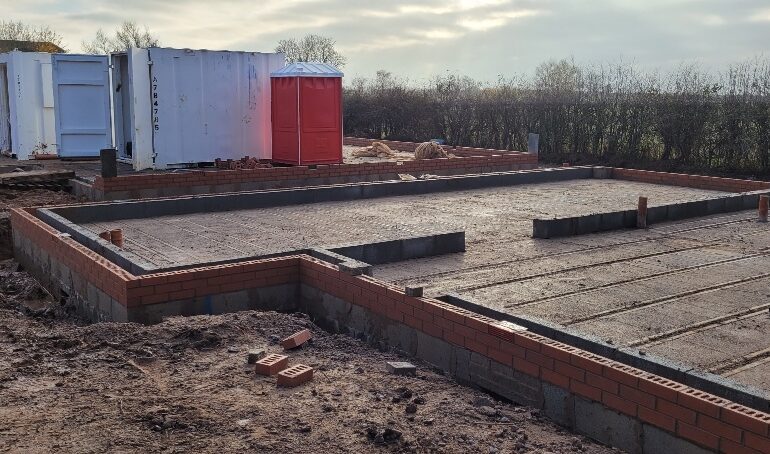

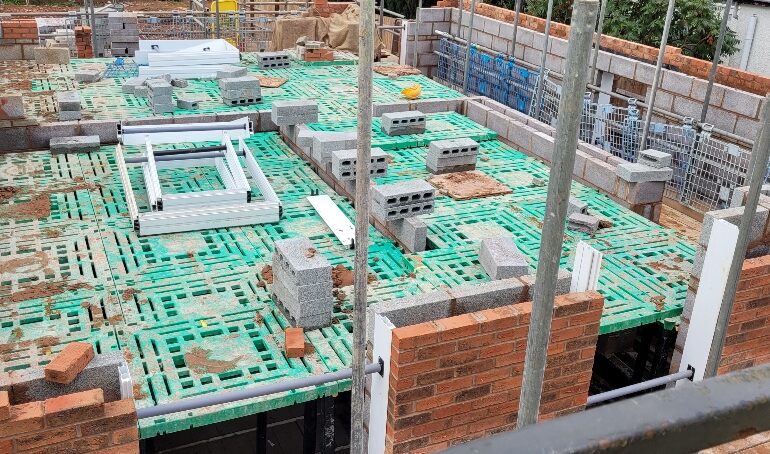

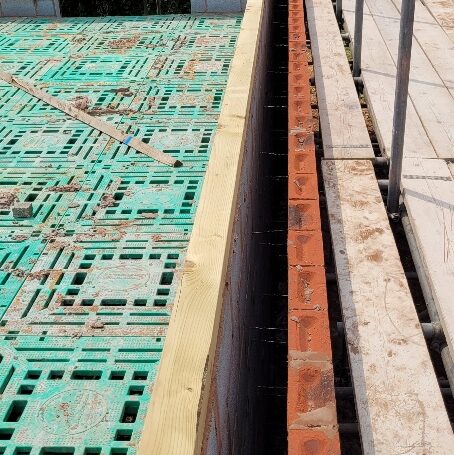

    Block and beam floors went in to the manufacturer's design with a damp-proof course under the beams.

  3. Station Road, Bagworth - Walls

    Aug 2023

    Walls

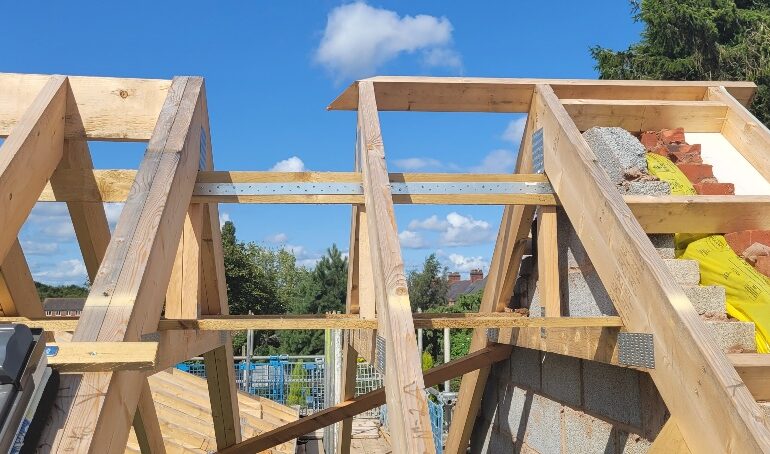

    Brickwork and blockwork went up in lifts across the plots.

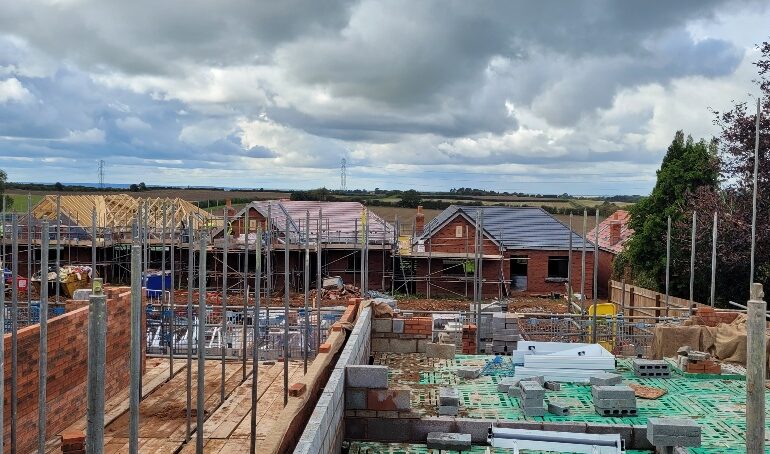

  4. Station Road, Bagworth - Roof

    Aug 2023

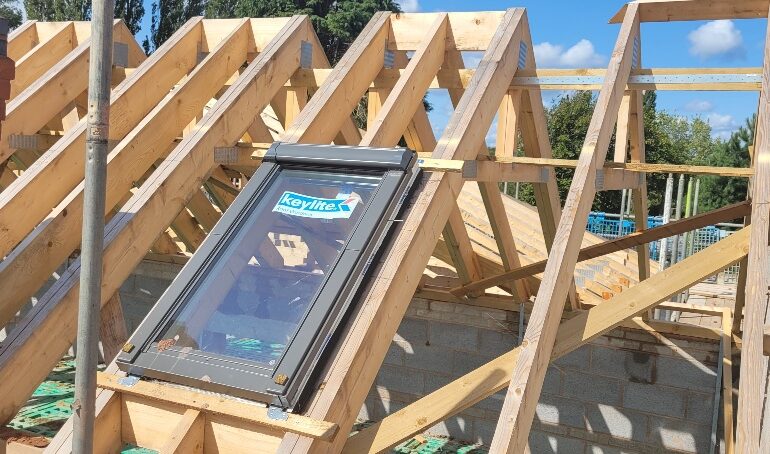

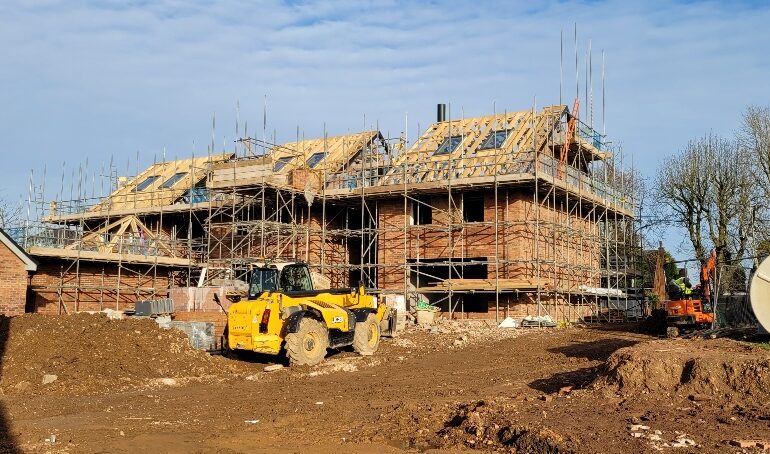

    Roof

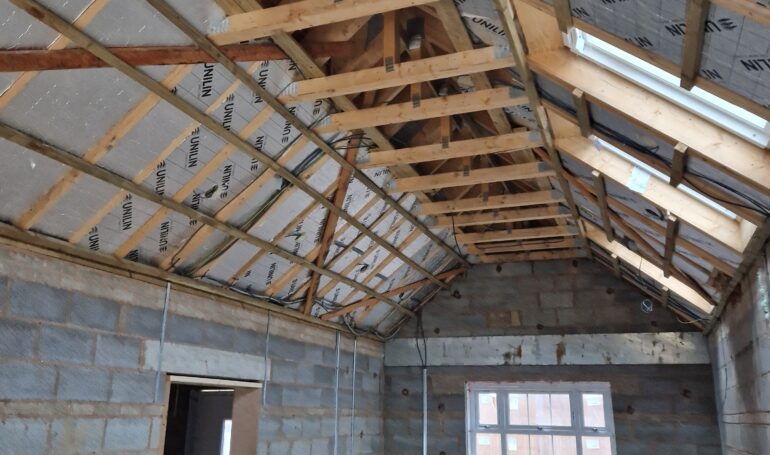

    Roof trusses were erected to the manufacturer's design with wall plate straps fixed.

  5. Station Road, Bagworth - First fix

    May 2024

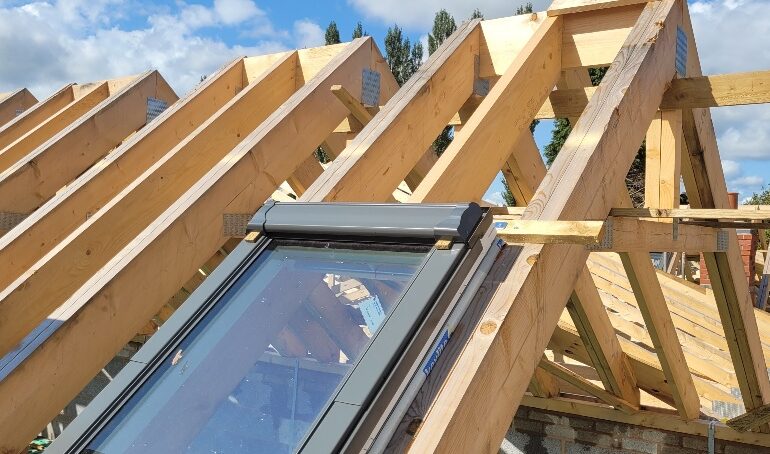

    First fix

    Roof tiling was complete with a mechanically fixed ventilated ridge and first fix was starting.

  6. Station Road, Bagworth - Complete

    Sep 2024

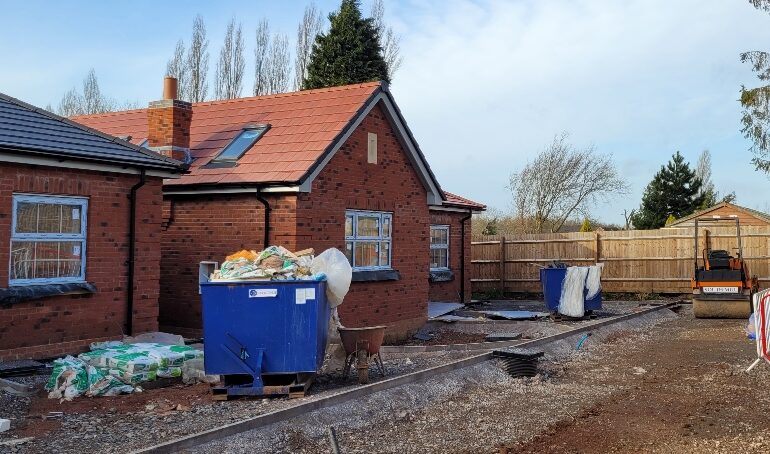

    Complete

    Drain tests were witnessed and all internal and external works were complete.
